Business Central Planning Engine Decisions: Item Card Configuration

In Business Central, the Item Card’s Planning tab includes key fields that control how and when items are replenished. These fields guide the planning engine’s decisions on supply orders.

Core Planning Fields on the Item Card

Item Card / Planning FastTab

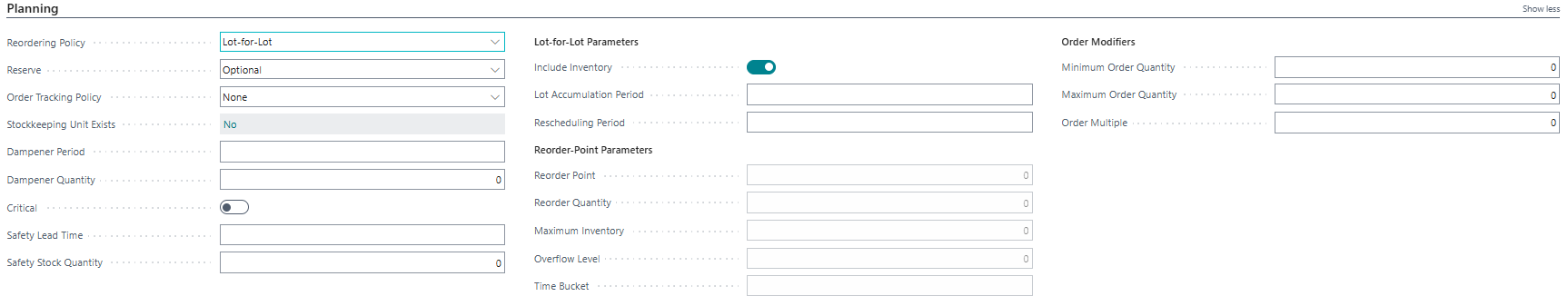

A screenshot of a computer

AI-generated content may be incorrect.

Reordering Policy

  • Purpose: Defines how the system calculates replenishment.
  • Options:
    • Fixed Reorder Quantity
    • Maximum Quantity
    • Order
    • Lot-for-Lot
  • Impact: Determines which other fields become editable and how supply is planned (e.g., per demand or in batches).

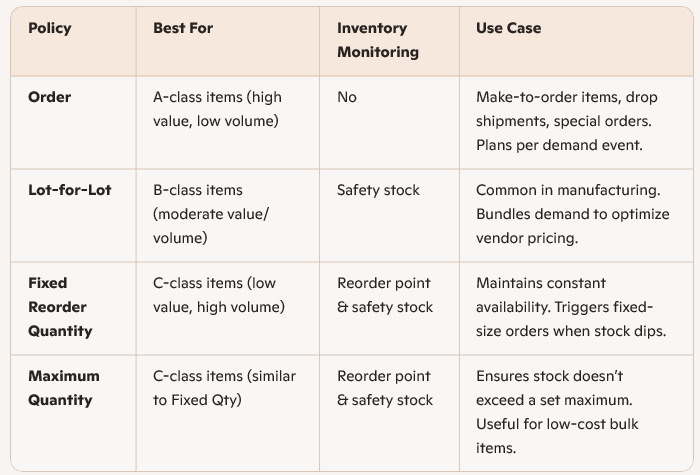

A chart of inventory monitoring

AI-generated content may be incorrect.

Reserve

  • Controls reservation behavior: Never, Optional, or Always.

Order Tracking Policy

  • Enables tracking of supply-demand links, affecting performance and visibility.

Time Bucket

  • Defines the interval for checking inventory levels under reorder point policies.

Dampener Period

  • Prevents frequent rescheduling by setting a buffer period.

Safety Stock Quantity

  • Buffer stock to prevent stockouts.

Safety Lead Time

  • Extra time added to ensure timely delivery before the demanding due date.

Lot for Lot

Lot Accumulation Period

  • Bundles multiple demands into one supply order within a defined period.

Rescheduling Period

  • Time window for adjusting existing supply orders to meet demand changes.

Fixed Reorder Qty and/or Maximum Qty

Reorder Point

  • Minimum inventory level before triggering a reorder.

Order Modifiers

  • Minimum Order Quantity
  • Maximum Order Quantity
  • Order Multiple: Ensures order quantities align with packaging or production constraints (e.g., multiples of 25).

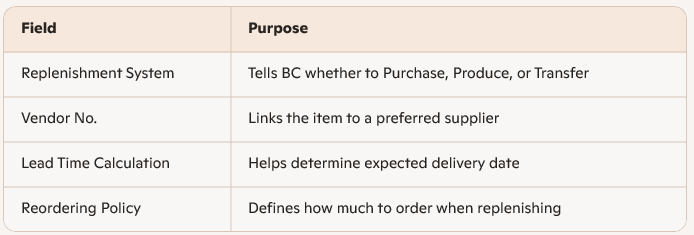

A screenshot of a computer

AI-generated content may be incorrect.

Replenishment System

Tells Business Central whether to Purchase, Produce, or Transfer.

A screenshot of a computer

AI-generated content may be incorrect.

Purchase

  • Restocked by purchasing it from a vendor—not by production or transfer

Manufacturing Policy

  • Make-to-Stock or Make-to-Order — influences how supply is triggered.
A screenshot of a computer

AI-generated content may be incorrect.

These fields work together to ensure that Business Central’s planning engine can generate accurate and efficient orders based on demand, inventory levels, and business rules. If you’re configuring items for planning, it’s crucial to understand how each field interacts with others to avoid unexpected results in MRP or requisition worksheets.

Sample Item Setup: ā€œBlue Widgetā€

We will sell a product called a Blue Widget. You want to ensure it’s always in stock but not overstocked.

Item Step-by-Step Configuration

Reordering Policy: Fixed Reorder Quantity

  • This means the system will always order a fixed quantity when inventory drops below the reorder point.

Reorder Point: 50 units

  • When inventory falls below 50, the system triggers a reorder.

Reorder Quantity: 200 units

  • Each time a reorder is triggered, 200 units are ordered.

Safety Stock Quantity: 25 units

  • Acts as a buffer to prevent stockouts due to unexpected demand.

Safety Lead Time: 2 days

  • Adds 2 days to the expected delivery time to account for delays.

Lot Accumulation Period: 7 days

  • Combines all demand within a 7-day window into one supply order.

Order Modifiers:

  • Minimum Order Quantity: 100
  • Maximum Order Quantity: 500
  • Order Multiple: 50 (ensure orders are placed in multiples of 50)

Dampener Period: 3 days

  • Prevents frequent changes to supply orders unless demand shifts significantly.

Rescheduling Period: 5 days

  • Allows the system to suggest rescheduling supply orders within a 5-day window.

Manufacturing Policy: Make-to-Stock

  • Items are produced or purchased in anticipation of demand.

How It Works in Practice

  • If inventory drops to 45 units, the system sees it’s below the reorder point (50) and triggers a reorder.
  • It checks modifiers: the reorder quantity is 200, which fits within the min/max and is a multiple of 50.
  • If multiple sales orders are due within the next 7 days, they’re bundled into one supply order.
  • If a supply order is already scheduled but demand shifts slightly, the dampener period prevents constant rescheduling.

This example will simulate how the Blue Widget behaves in a Planning Worksheet in Business Central based on the setup defined. This will show you how the system reacts to inventory levels and demand.

Scenario: Planning Worksheet Simulation

Setup Recap:

  • Reorder Point: 50 units
  • Reorder Quantity: 200 units
  • Safety Stock: 25 units
  • Current Inventory: 60 units
  • Sales Order: 30 units due in 3 days
  • Reordering Policy: Fixed Reorder Quantity
  • Lot Accumulation Period: 7 days

Step-by-Step Simulation

1. Demand Hits

  • A sales order for 30 units is placed.
  • Inventory drops from 60 → 30 units.

2. Planning Engine Triggers

  • Inventory (30) is now below the Reorder Point (50).
  • Planning Worksheet suggests a Purchase Order or Production Order for 200 units.

3. Lot Accumulation

  • If another sales order for 20 units is due within the next 7 days, it’s bundled into the same supply order.
  • Total demand = 50 units → still triggers one supply order of 200 units.

4. Safety Stock Consideration

  • The system ensures that after fulfilling demand, at least 25 units remain in stock.

5. Order Modifiers Check

  • 200 units is:
    • Above the Minimum Order Quantity (100)
    • Below the Maximum Order Quantity (500)
    • A multiple of 50

6. Rescheduling & Dampener

  • If the delivery date shifts slightly, the system checks:
    • Is it within the Rescheduling Period (5 days)?
    • Is it outside the Dampener Period (3 days)?
  • If yes, it may suggest rescheduling the supply order.

Planning Worksheet Output

A screenshot of a calculator

AI-generated content may be incorrect.

Customer Item Card Configuration

Replenishment = Purchase

Lead Time = 5D

Safety Stock = 2,450#: Minimum Order and Order Multiple = 2,450#

Start Production Use = 10/13/2025 – Lead Time 5D = Purchase Date Due 10/08/2025

Calculate Regenerative Plan MRP

A screenshot of a computer

AI-generated content may be incorrect.

No Supply Demand – Customer

Supply Demand = Safety Stock 2,450#

Purchase Order Requirement = Order Date 10/08/2025 to have Expected Receipt 10/13/2025

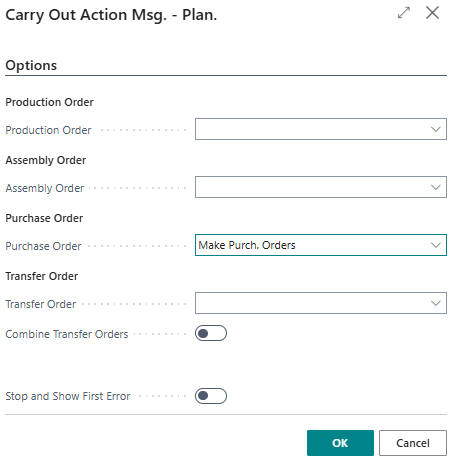

Carry out Action Message = New

Create the Purchase Order Automatically

A screenshot of a computer screen

AI-generated content may be incorrect.

The Planning Worksheet in Microsoft Dynamics 365 Business Central is fundamentally a date-driven supply and demand engine. Every planning suggestion it creates is based on calculating:

  • When demand occurs
  • When supply is available
  • How long replenishment takes
  • What dates must be used to avoid shortages or excess inventory

Understanding how dates are calculated is the key to understanding why Business Central creates:

  • Action Messages
  • Requisition lines
  • Transfer suggestions
  • Production Orders
  • Purchase Orders
  • Reschedule messages
  • Cancel messages

1. Core Planning Concept

Planning works backward from demand dates. Business Central asks:

ā€œWhen must supply exist so inventory is available on the demand date?ā€

Then it subtracts:

  • Lead times
  • Safety lead time
  • Manufacturing times
  • Queue times
  • Vendor times
  • Transfer times
  • Calendars
  • Dampener rules
  • Rescheduling rules

The result becomes:

  • Order Date
  • Starting Date
  • Ending Date
  • Due Date

2. The Three Most Important Dates in Planning

Demand Date

The date inventory is required.

Examples:

  • Sales Shipment Date
  • Production Component Need Date
  • Transfer Shipment Date
  • Service Order Date
  • Forecast Date

This is the anchor date.

Due Date

The date replenishment must be available.

For:

  • Purchase Orders → Expected Receipt Date
  • Production Orders → Ending Date
  • Transfer Orders → Receipt Date

Usually:

Due Date = Demand Date

Unless offsets or safety time exists.

Order Date

The date planning says you must start procurement or production.

Calculated backward from Due Date.

3. The Master Date Calculation Formula

The general planning formula is:

Purchase Orders

Order Date = Due Date – Vendor Lead Time – Safety Lead Time – Inbound Warehouse Handling Time

Production Orders

Starting Date = Ending Date – Routing Times – Queue Time – Move Time – Wait Time – Safety Lead Time

Transfer Orders

Shipment Date = Receipt Date – Transfer Time – Outbound Warehouse Handling – Shipping Time

4. Planning Worksheet Date Flow

The Planning Worksheet processes dates in this sequence:

Demand Date
↓
Projected Inventory
↓
Netting
↓
Reorder Policy Logic
↓
Lead Time Calculation
↓
Calendar Validation
↓
Action Message Creation

5. Where Business Central Gets Date Information

A. Item Card

Reordering Policy

Determines HOW dates are generated.

Common:

  • Fixed Reorder Qty.
  • Maximum Qty.
  • Lot-for-Lot
  • Order
  • Blanket Order

Safety Lead Time

Extra protection days added before demand.

Example:

Demand Date = May 30
Safety Lead Time = 3D
Adjusted Due Date = May 27

Lead Time Calculation

Default replenishment lead time.

Can represent:

  • Vendor time
  • Internal production time
  • Assembly time

Example:

Lead Time = 14D
Due Date = May 27
Order Date = May 13

Dampener Period

Controls sensitivity to date changes.

Prevents nervous planning.

Example: If the supply moves only 1 day and the dampener is 3 days:

  • No reschedule message created.

Rescheduling Period

Defines acceptable date movement window.

6. Vendor Dates and Purchasing

Vendor Card and SKU can override dates.

Vendor Lead Time Hierarchy

Planning uses:

  1. SKU Vendor Lead Time
  2. Item Vendor Catalog
  3. Vendor Lead Time
  4. Item Lead Time Calculation

Purchase Order Example

Demand:

Sales Order Shipment Date = June 30

Settings:

Vendor Lead Time = 10D
Safety Lead Time = 2D
Inbound Handling = 1D

Calculation:

Need By Date = June 30
Adjusted Due Date = June 27
Order Date = June 17

Result:

PO Order Date = June 17
Expected Receipt Date = June 27

7. Manufacturing Date Calculations

Manufacturing is more complex because routing drives dates.

Planning uses:

  • Routing Setup Times
  • Run Times
  • Wait Times
  • Move Times
  • Queue Times
  • Calendar Capacity

8. Forward vs Backward Scheduling

Backward Scheduling (Most Common)

Starts from demand date.

Need Finished Good on June 30
↓
Subtract manufacturing time
↓
Start Production June 20

Forward Scheduling

Starts today and calculates finish date.

Used when:

  • Late orders
  • Capacity overloads
  • Manual scheduling

9. Low-Level Code and Pegging Impact on Dates

Planning processes:

  • Parent demand
  • Then component demand

Using: Low-Level Codes

This creates dependent dates.

Example

Finished Good:

Need Date = June 30

Production requires component 5 days earlier.

Component Demand Date: June 25

Vendor lead time: 7 days

Purchase Order Date: June 18

This is called:Dynamic Date Pegging

10. Action Messages and Date Logic

Planning compares:

  • Existing supply dates vs Required dates

Then generates messages.

Reschedule Forward

Supply too early.

Example:

PO Receipt = June 1
Need Date = June 20

Suggestion:

Reschedule Forward to June 20

Reschedule Back

Supply too late.

Example:

PO Receipt = June 28
Need Date = June 20

Suggestion:

Reschedule Back to June 20

Cancel

Supply no longer needed.

Change Quantity

Dates remain valid but quantity incorrect.

11. Planning Flexibility and Dates

Supply orders can be:

  • Unlimited
  • None

Unlimited: Planning can move dates.

None: Planning cannot modify dates.

This is critical. Frozen orders prevent date optimization.

12. Calendars and Working Days

Business Central adjusts dates using:

  • Base Calendars
  • Vendor Calendars
  • Location Calendars
  • Shop Calendars

Example

If calculated order date lands on Sunday: June 15

Planning moves to: June 16

Depending on calendar setup.

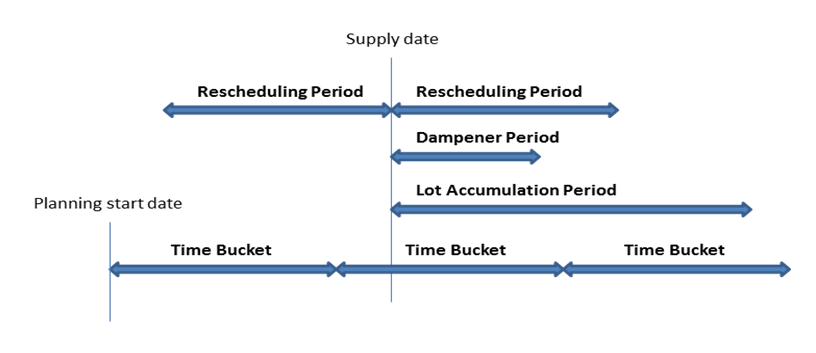

13. Time Buckets and Date Consolidation

For Lot-for-Lot:

  • Each demand can create separate dates.

For Time Bucket:

  • Demands inside bucket consolidate.

Example

Time Bucket = 7D

Demands:

June 1
June 3
June 5

Planning creates: Single supply date, instead of three separate orders.

14. Safety Stock and Date Effects

Safety stock creates earlier replenishment.

Planning protects: Projected Inventory >= Safety Stock

This often shifts dates earlier than actual demand.

15. Forecast Dates

Forecast entries become demand dates.

Planning calculates:

Forecast Date
↓
Net Demand Date
↓
Supply Due Date
↓
Order Date

Forecast consumption modifies these dates dynamically.

16. Planning Worksheet Calculation Sequence

When you run:

Calculate Regenerative Plan

Business Central:

Step 1

Explodes BOM demand dates.

Step 2

Calculates projected inventory timeline.

Step 3

Applies reorder policies.

Step 4

Calculates replenishment dates.

Step 5

Applies calendars.

Step 6

Creates action messages.

17. Dynamic Tracking and Date Changes

One sales order date change can ripple through:

  • Production Orders
  • Purchase Orders
  • Transfer Orders
  • Component demand

This is why planners experience nervousness

18. Why Dates Sometimes Look Wrong

Usually caused by: Incorrect Lead Times

Most common issue: Missing Calendars

Causes unrealistic weekends.

Incorrect Routing Times

Production dates compress incorrectly.

Safety Lead Time Too Large

Everything shifts earlier.

Dampener Settings

Suppresses expected changes.

Planning Flexibility = None

Prevents optimization.

19. Critical Fields That Affect Dates

Item Card

  • Lead Time Calculation
  • Safety Lead Time
  • Reordering Policy
  • Dampener Period
  • Rescheduling Period
  • Lot Accumulation Period

SKU Card

  • Lead Time
  • Vendor
  • Transfer Time

Vendor

  • Lead Time Calculation
  • Base Calendar

Manufacturing Setup

  • Default Dampener
  • Combined MPS/MRP
  • Dynamic Low-Level Code

20. Example Full End-to-End Date Calculation

Scenario

Sales Order:

Shipment Date = July 30
Qty = 100

Finished Good:

Production Time = 5D
Safety Lead Time = 2D

Component:

Vendor Lead Time = 10D

Step 1 — Finished Good Due Date

July 30

Step 2 — Production Start Date

July 30
– 5D
– 2D

= July 23

Step 3 — Component Demand Date

Component needed at production start:

July 23

Step 4 — Purchase Order Date

July 23
– 10D

= July 13

Final Result

Planning Worksheet creates:

Order Type

Order Date

Due Date

Purchase Order

July 13

July 23

Production Order

July 23

July 30

21. The Most Important Planning Concept to Teach Users

Planning is NOT:

“What do I need?”

Planning is:

“When do I need it?”

Everything in Business Central planning revolves around:

  • Demand dates
  • Supply dates
  • Lead times
  • Calendar logic
  • Dynamic pegging

22. Best Practice Recommendations

Always Maintain:

  • Accurate vendor lead times

  • Accurate routing times

  • Calendars

  • Safety lead times

  • Planning flexibility rules

Avoid:

  • Zero lead times
  • Blanket use of Lot-for-Lot
  • Ignoring dampeners
  • Frozen supply orders
  • Missing SKU planning parameters

23. Advanced Planning Concepts

Emergency Orders

Created when:

Order Date < WORKDATE

Date Conflict Resolution

Planning prioritizes:

  1. Demand fulfillment
  2. Safety stock
  3. Existing supply reuse
  4. Rescheduling before new orders

Planning Horizon

Orders outside horizon may not generate.

24. Key Teaching Message

The Planning Worksheet is essentially a giant date calculation engine that:

  • Calculates shortages over time
  • Offsets supply dates backward
  • Dynamically links supply and demand
  • Continuously recalculates based on changing dates

Understanding:

  • Lead times
  • Due dates
  • Starting dates
  • Calendars
  • Pegging

is what separates basic users from expert planners in Microsoft Dynamics 365 Business Central.

The timing of rescheduling period, dampener period, and lot accumulation period is based on a supply date. The time bucket is based on the planning start date, as shown in the following illustration.

Time bucket elements.

In the following examples, the black arrows represent existing supply (up) and demand (down). Red, green, and orange arrows are planning suggestions.

Example 1: The changed date is outside the rescheduling period, which causes the existing supply to be canceled. A new supply is suggested to cover the demand in the lot accumulation period.

Rescheduling and lot accumulation periods.

Example 2: The changed date is in the rescheduling period, which causes the existing supply to be rescheduled. A new supply is suggested to cover the demand outside the lot accumulation period.

Rescheduling period, lot accumulation period, and reschedule.

Example 3: There’s a demand in the dampener period and the supply quantity in the lot accumulation period matches the supply quantity. The next demand is uncovered and a new supply is suggested.

Dampener period and lot accumulation period.

Example 4: There’s a demand in the dampener period and the supply remains on the same date. However, the current supply quantity doesn’t cover the demand in the lot accumulation period. A change quantity action for the existing supply order is suggested.

Dampener period, lot accumulation period, and change quantity.

Default values: The default value of the Time Bucket field and the three reorder period fields are blank. For all fields, except the Dampener Period field, this means 0D (zero days). If the Dampener Period field is blank, the global value in the Default Dampener Period field on the Inventory Setup page is used.

Welcome to our new site!

Here you will find a wealth of information created for peopleĀ  that are on a mission to redefine business models with cloud techinologies, AI, automation, low code / no code applications, data, security & more to compete in the Acceleration Economy!
